| Step 4:
              Assigning Resources to
              Tasks
            As long as the
            resources are not assigned to tasks, the project has duration but
            no work or cost is associated with the project . You can see this
            in the Project Statistics window.
             Checkpoint:

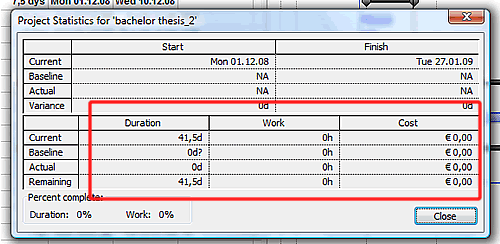

 Check the project duration in the project statistics window:
 The current duration of the project is 41,5 days,
              the work is 0 hours and the cost is 0 €. Tip: If you cannot remember how to view the Project Statistics
              window, go back to the Checkpoint of Step 1 in this tutorial. Now you are ready to assign the resources from the resource pool
              to the tasks. An assignment is the matching of a resource
              to a task to do the work. MS Project then automatically calculates
              the costs of the resources and the task for you.
 Assignment = Task + Resource Assigning resources to tasks in your project plan allows you to
              answer the following questions:

              Who should
                be working on what task and when?Do you have
                the right number of resources to accomplish the work your project
                requires?Are you expecting
                a resource to work on a task at a time when that resource will
                not be available to work (e.g. holiday)?Have you
                assigned a resource to so many tasks that you have exceeded the
                capacity of the resource to work - in other words have you overallocated
                that resource? Before you assign a resource to a task, the task has duration
              but no work associated with it. Work represents the
              amount of effort a resource or resources will spend to complete
              a task. For instance, if you have one person working full-time (i.e.
              100%), the amount of time measured as work is the same as the amount
              of time measured as duration. In general, the amount of work will
              match the duration unless you assign more than one resource
              (i.e. units) to a task or the one resource is not working full-time.
             As already mentioned in step 1 of this tutorial, the relationship
              between work, duration and units is calculated by means of the
              scheduling formula: Work = Duration x Units Exercise:

              For assigning resources you have to switch from the Resource

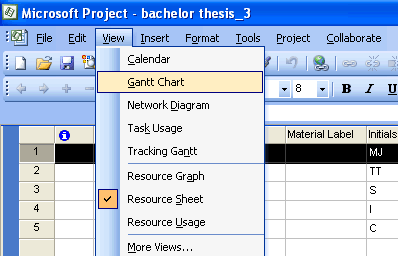

                Sheet view to the Gantt-Chart view:

              In the Gantt-Chart view select the task to which
                you want to assign resources by clicking on the task name.
                Select task 2 in our task list 'Think or what I want to
                do'.

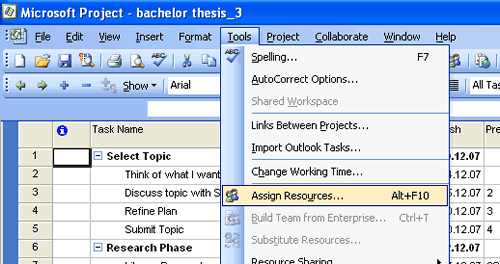

In the main menu bar click on Tools and select 'Assign
                Resources ...'

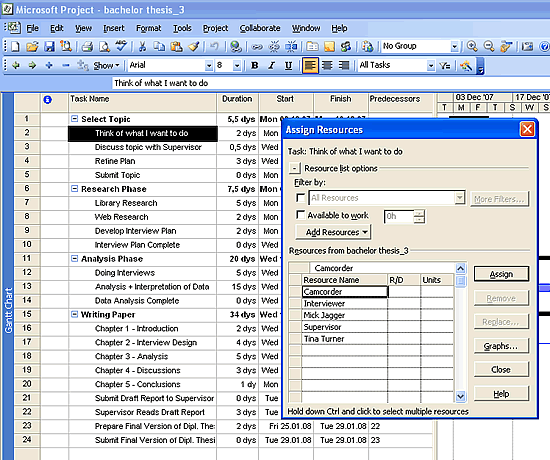

              The Assign Resources dialog box opens in which
                all the resources from the resource pool are listed alphabetically:

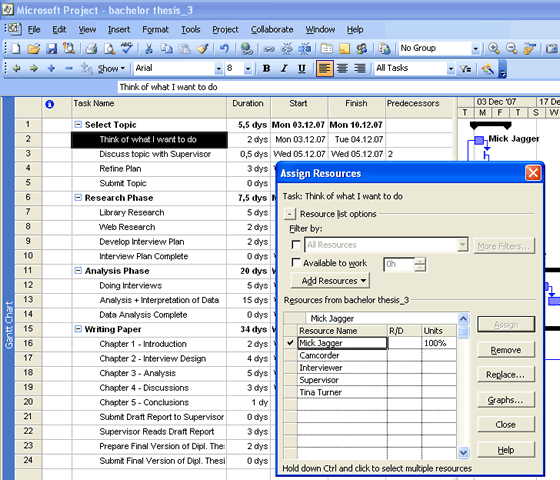

              Assign the project leader Mick Jagger to task 2 by
                clicking on Mick Jagger in the Resource Name column
                and then click the Assign button:

              A check mark appears next to Mick Jagger's
                name, indicating that you have assigned him to task 2. The resource's
                name also appears next to the blue bar in the Gantt Chart.

Task 3 'Discuss topic with Supervisor' requires the resources
                Mick Jagger and the Supervisor. You can leave the
                Assign Resources dialog box open and click on task 3 in

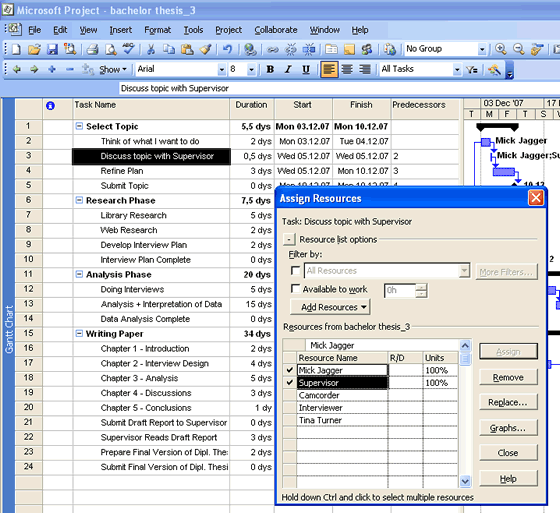

                the task list. You can assign multiple resources to a task
                by clicking on Mick Jagger first, hold down the Ctrl-key
                on the keyboard, click Supervisor, and then click the Assign
                button. Your screen should look similar to the following illustration:

              Assign Mick Jagger to the tasks 4, 5, 7, 8,
                9 and 10. For task 12 'Doing Interviews' assign the resources
                Interviewer and Camcorder by clicking first on Interviewer,
                hold the Ctrl key and then select Camcorder and eventually click
                the Assign button.

Further, assign Mick Jagger to the tasks 13, 14, 16,
                17, 18, 19, 20, 21, 23 and 24. Assign the Supervisor to
                task 22.

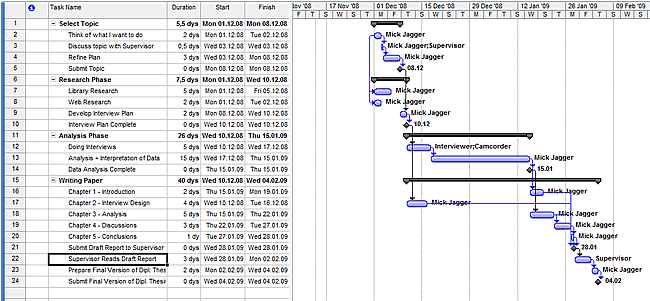

Your screen should now look similar to the following illustration:
 Congratulations! You have now assigned resources to all
              tasks. That was hard work, wasn't it? But imagine you lead a project
              with about 100 tasks and up to 10 different resources - MS Project
              can then help you a lot to manage the work and the resources of
              your project. In the next step you will assign additional resources to
              a task after the first assignment to see the effect on the overall
              duration of the tasks. |
